MAJOR OVERHAUL 3 X 37 MW MITSUBISHI TURBINE GENERATOR PT. LONTAR PAPYRUS PULP AND PAPER
GENERAL SCOPE OF WORK
1. Pre-Inspection before shut down
2. Dismantle unit of Generator

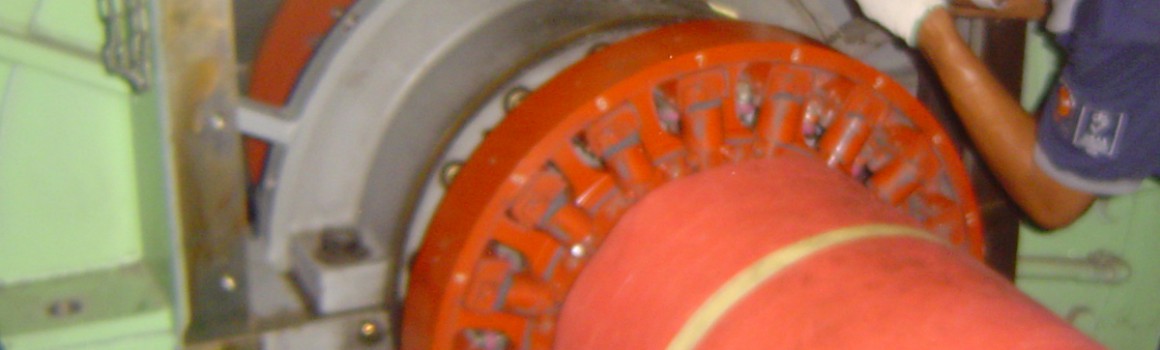

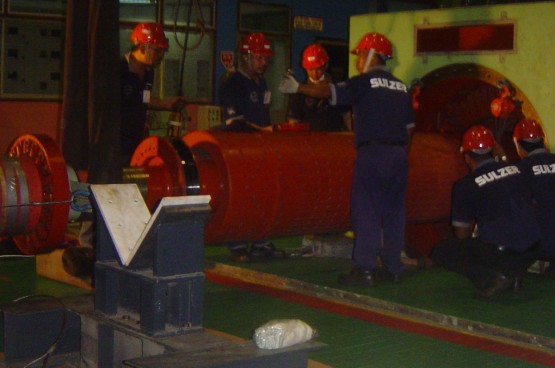

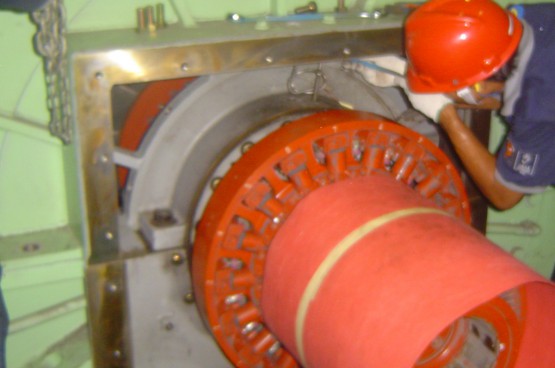

3. Pull out main rotor from stator

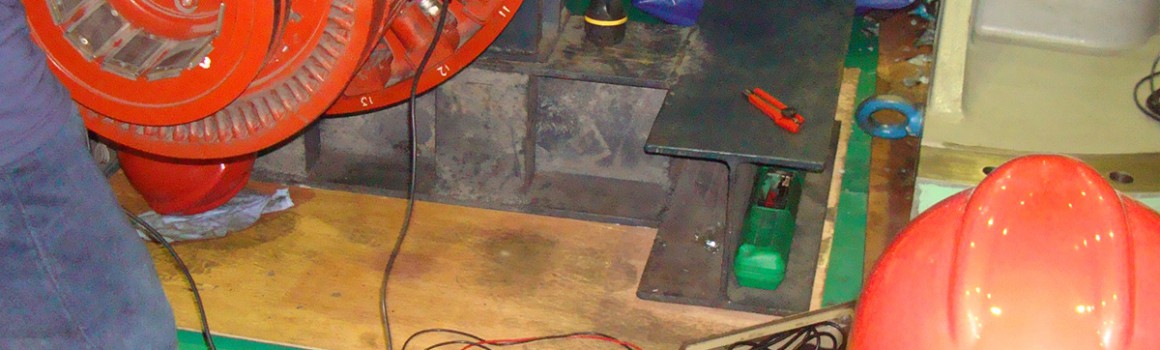

4. Electrical and Mechanical Inspection
5. Clean and Inspect all generator components

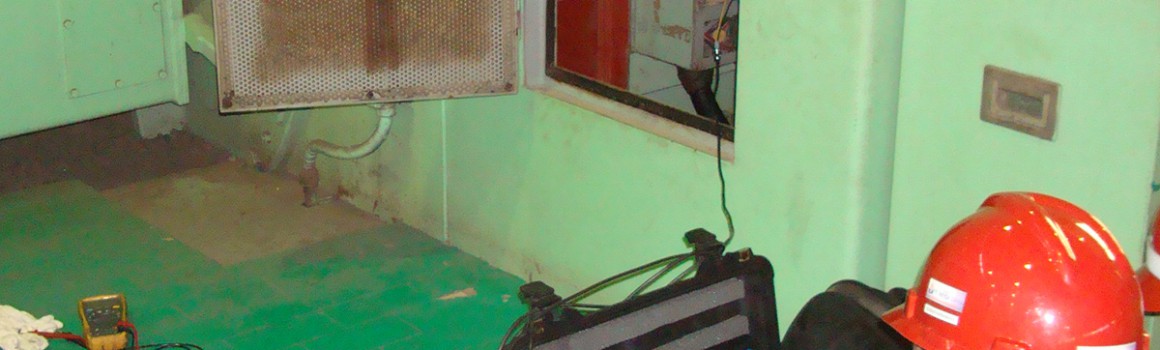

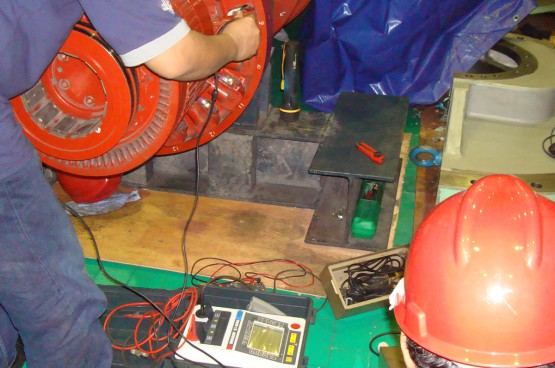

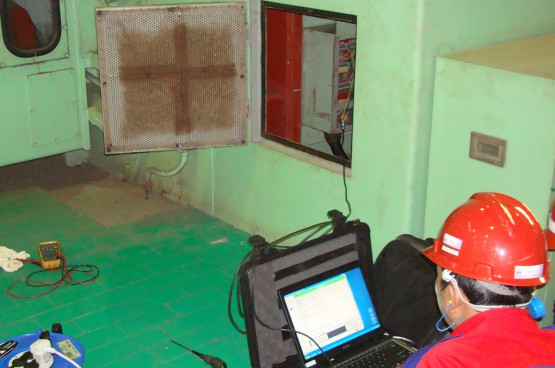

6. Electrical test of stator, rotor winding & exciter
7. Inserting Rotor to Stator
8. Completed re-assembly generator
9. Final alignment generator with turbine
10. Commissioning test and completion all reported
